Building Envelope Project Update
Current Updates

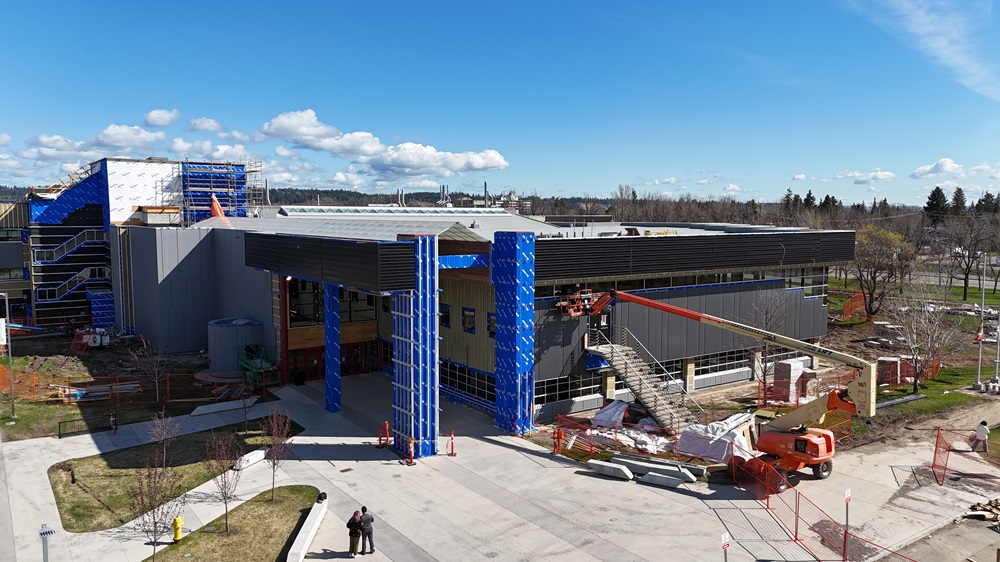

Building envelope work continues across the Prince George Campus, including exterior finishing, landscaping, perimeter lighting, and skylight replacement.
Work is taking place in the 200, 300, 400, 500, and 700 Blocks, the main courtyard, and surrounding exterior areas. Scaffolding installation is underway at the Main Entrance atrium and near the second-floor Learning Commons in preparation for skylight replacement. Work will continue through October and into early November.
The Main Entrance and Learning Commons remain open during construction.
Accessible parking near the Main Entrance has been relocated until further notice to the crosswalk ramp, and a detour is in place for those walking from the east side.
Check the full map to see how campus blocks are connected and where work is taking place.
Expected Impacts
🔊 Noise: Construction noise is expected from exterior wall work, soffit framing, scaffolding installation, skylight replacement, and other construction activities. Increased noise may occur near the Main Entrance and Learning Commons after 4:00pm.
đźš§ Access: Temporary barriers and localized detours may be in place near active work areas. Scaffolding installation directly outside the Learning Commons is expected after 8:00pm. Access to the Learning Commons will be maintained, although temporary corridor detours may be needed.
🌱 Landscaping: Landscaping continues in the main courtyard and around the 700 Block, including ground preparation, sod installation, and weather-dependent concrete work.
đź‘· Construction Activity: Scaffolding installation, skylight replacement, exterior panels, siding, canopy work, soffit framing, perimeter lighting, painting, and other finishing activities will continue through October and into early November. Temporary disruptions to nearby services may occur.
Please allow extra time when travelling through campus and follow posted signage and detours.
Upcoming Activities
October 19–25
200 Block
- Install exterior finish panels
300 Block North
- Install clips and metal framing 🔊
- Install insulation
- Install trim and exterior panels
400 Block
- Continue soffit framing for perimeter lighting
- Begin perimeter lighting work
700 Block
- Continue east entrance civil work
- Continue preparation for sod 🌱
- Begin skylight demolition and installation
- Continue skylight scaffold work
Main Courtyard
- Continue landscaping 🌱
October 26–November 1
200 Block
- Continue exterior finish panel installation
300 Block North
- Continue trim and exterior panel installation
400 Block
- Continue soffit framing for perimeter lighting
- Continue perimeter lighting wiring, preparation and installation
700 Block
- Continue skylight demolition and installation
- Continue skylight scaffold work
West Parking Lot
- Remove construction materials from the snow dump area
About the Project
The Building Envelope Project is designed to enhance the exterior of the Prince George Campus through energy-efficient upgrades, improved sustainability, and long-term infrastructure renewal. These improvements will help create a more comfortable and resilient campus for students, employees, and visitors.
This project is made possible with restricted capital funding by the Ministry of Infrastructure.
The Building Envelope Project supports CNC’s Strategic Plan (lhulh whuts’odutel’eh – Learning Together) under Priority 3.5: Rejuvenate College Infrastructure. Specifically, it supports objectives 3.5.1 through 3.5.4 by upgrading campus infrastructure, revitalizing learning spaces, improving sustainability, and helping reduce the college’s overall carbon footprint.
Key Highlights of the Project:
- Energy-efficient building upgrades
- Modernized campus exterior
- Improved long-term durability and sustainability
Project Timeline
- March 2025: Project mobilization and site preparation
- May 2025: Construction begins
- Summer–Fall 2025: Demolition and exterior renewal work
- Winter 2025–26: Interior and exterior finishing activities
- Spring 2026: Major exterior upgrades continue across campus
- Estimated Completion: May 2027
Impact on Campus
- We are committed to minimizing disruptions during construction. Updates will be provided regarding:
- Campus accessibility
- Temporary disruptions and detours
- Changes to parking, entrances, and pedestrian routes
- Our team is focused on ensuring that the impact on your daily experience is as minimal as possible.
Building Envelope Project FAQ
Why does some of the new siding look wavy?
Some members of the campus community may notice slight waviness or “ripples” in portions of the new metal siding. This effect, known as oil canning, is a common characteristic of flat metal siding and is widely recognized across the construction industry.
Oil canning is a visual effect only. It does not affect the strength, safety, durability, or weather protection of the building. The project team continues to monitor installation quality to ensure the work meets project requirements and industry standards.
The effect is often more noticeable in certain lighting and typically becomes less noticeable over time.
Read more about siding appearance
